In April 2026, neighbors rebuilt the crossing where the Monon Trail meets 16th Street.
Then we measured what changed, and asked the neighborhood what should happen next. 123 people
answered. This page is the short version: what the data shows, and what we have asked the City
to do.
On April 25, 2026, approximately 110 volunteers painted curb bump-outs in all four
quadrants of the 16th Street crossing, narrowed the street to one travel lane in each direction with
weighted delineators and flexible posts, and restored legal on-street parking on 16th Street by
removing old signs. The work was done through the City's Community Powered Infrastructure program
at a cost of $5,494. What follows is what we learned afterward.

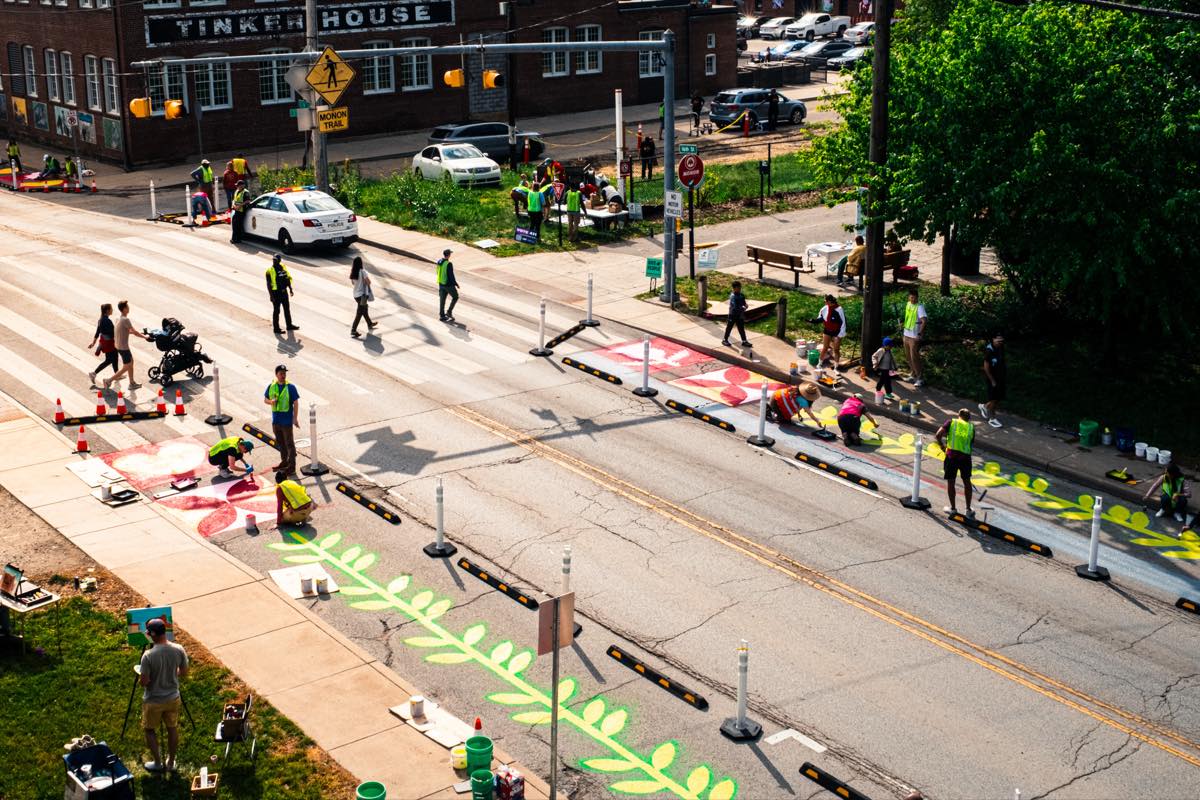

April 25, 2026. Volunteers painting the four quadrants of the crossing.
What the build changed
Resident-run speed and safety study: about 8,900 vehicle observations across 30
sessions
Neighborhood volunteers counted traffic for four weeks before the build and four weeks after it. The
results were shared with the Department of Public Works on May 31, 2026. Every measure moved in the
same direction.
21.5 → 17.5average speed, mph
29 → 2285th percentile speed, mph
26.7% → 6.8%share of drivers over 25 mph
22 → 3severe conflicts per session
Measure
Before
After
Average speed
21.5 mph
17.5 mph
85th percentile speed
29 mph
22 mph
Share of drivers over 25 mph
26.7%
6.8%
Severe conflicts per session
22
3
The full observation-level data is published further down this page, so anyone can check the numbers
against the source.
What neighbors told us
Community survey, 123 responses, open continuously June 11 to July 11, 2026
We worked with Health by Design on a short survey about what people noticed since the build and what
they want the area to become. It ran for a month and was frozen on July 15, 2026 at 123 responses.
Respondents were people from the surrounding neighborhood (56), people who live on or next to the
trail (31), trail users from elsewhere (25), business owners and workers (10), and one occasional
visitor.
97%felt safer since the build (119 of 123)
96%feel safe crossing now (118 of 123)
94%want to keep or improve the safer design (116 of 123)
One respondent of 123 asked to return to the original layout.
What people want for the strip
The open public land south of 16th Street, between Lewis Street and the trail
The survey asked directly what that ground should become. The five options below are mutually
exclusive, so they add up to all 123 responses.
All community use63 of 123 (51%)
Mostly community space, a little parking24 of
123 (20%)
An even split16 of 123 (13%)
Mostly parking, a little community space10 of
123 (8%)
All parking10 of 123 (8%)
How the groupings work
Combining the first three options gives a community-first preference of 103 of 123 (84%).
Combining the last two gives a parking-leaning preference of 20 of 123 (16%), of which 10 (8%)
asked for all parking. These groupings are cumulative roll-ups of the five options above, not a
second way of dividing the same 123 people.
What people would actually use
Amenities respondents said they wanted, multiple selections allowed, n = 123
Shade trees and native plantings106
(86%)
Safer trail connections to the Lewis Street businesses89 (72%)
Water fountain or bottle filler89
(72%)
Benches and seating86 (70%)
Public art82 (67%)
More parking19 (15%)
We also asked what would bring people to the businesses near the crossing more often. The answers
were mostly about the walk there.
More greenery and shade99 (80%)
Safer, calmer crossings92 (75%)
Places to sit and linger79 (64%)
Events, markets, and programming73
(59%)
Better trail access59 (48%)
Easier parking17 (14%)
What the survey also found
20 of 123 respondents (16%) preferred a parking-leaning outcome for the strip, and 10 of those
asked for all parking. We report that alongside everything else, because a survey that publishes
only the majority is not evidence.
Of the 88 people who answered the question, 10 reported witnessing a close call or a crash at the
crossing since the build, including one account of a pedestrian being struck. We report it for
the same reason, and we read it as a case for making the safety design permanent rather than a
reason to doubt it.
What we have asked the City
Addressed to the Department of Public Works and the Department of Metropolitan
Development
Our three requests
Make the safety improvements permanent.Carry the geometry into
the corridor capital project in concrete. 116 of 123 respondents (94%) want to keep or
improve the safer design.
Designate the trail-edge strip for community activation.Not for
parking, and consistent with the space the capital design already reserves beside the trail.
103 of 123 (84%) asked for a community-first outcome.
Schedule a debrief on the safety data.A structured conversation
with the coalition and (re)vision16 about the before and after results we submitted on
May 31, 2026.
Through our conversations with the Department of Public Works, we understand the corridor capital

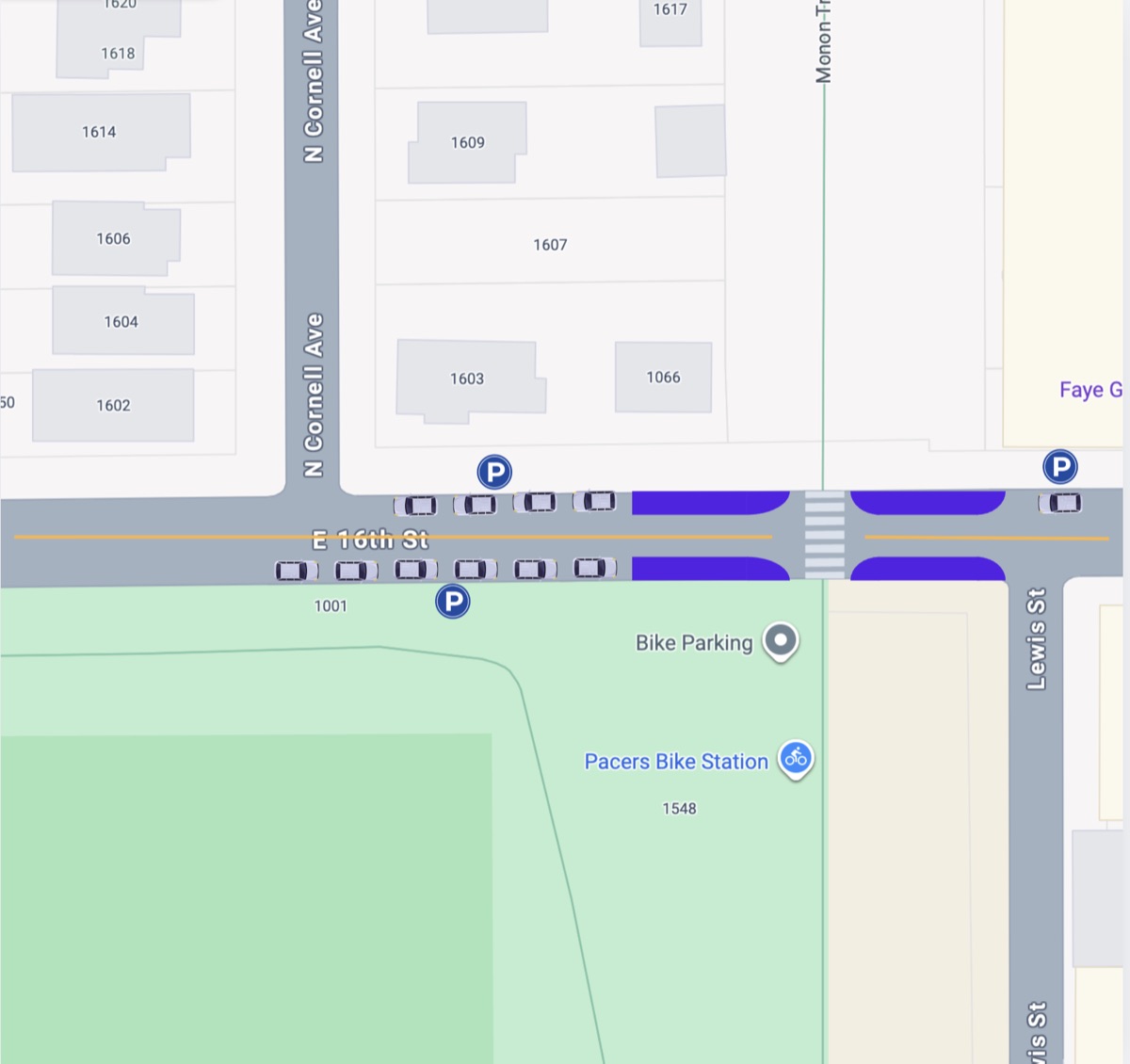

project to include 16th Street restriped to two travel lanes with parallel parking along both sides. We
also understand it to leave roughly 40 feet between that parking and the trail for potential
activation uses. Design work is ongoing and details may have moved since we last discussed them.
What residents asked for fits inside that reserved space.
The shape of the request: parking along 16th Street, calmer corners at the crossing, and
the strip beside the trail kept open for people.
How this fits the City's and the region's plans
The request follows existing adopted policy rather than asking for an exception
None of this is a new idea. What neighbors asked for lines up with the planning framework Indianapolis
and Central Indiana already have on the books.
"Parking should be located on the sides or rear of buildings, not adjacent to the trail." Where
trail-adjacent parking already exists, it "should be used as flex space for food trucks and pop-up
events."
Central Indiana Trail-Oriented Development Study, IMPO, March 2024
IMPO Central Indiana Trail-Oriented Development Study
The Indianapolis Metropolitan Planning Organization is the federally designated transportation
planning body for Central Indiana. Its March 2024 study is specific about what belongs at a
trail edge, and about designing land use around trail users rather than around car storage.
Adopted in 2014 and now advancing an update, the Full Circle plan is a supporting document of
the Marion County comprehensive plan. The Monon is the spine of the system it describes, and
it sets systemwide standards for safety, accessibility, and funding eligibility.
The City's Department of Metropolitan Development recognizes neighborhood-prepared land use
plans that meet its standards for public engagement and content. Certification is not an
ordinance and carries no funding, but it creates a pathway for a neighborhood's plan to
inform the official Comprehensive Plan.
Certified in 2025, this resident-led plan is the nearby certified example, and per DMD its
boundary extends to the Monon. It is the model for how a neighborhood in this part of the
city turns community engagement into a document the City will consider.
The economics point the same way. The Monon carries an estimated 1.3 million users a year through
Indianapolis (Rails-to-Trails estimate). In Carmel, redevelopment officials estimate the trail has
helped attract more than $250 million in development since it was built (Carmel Redevelopment, via
Rails-to-Trails). The pattern in both cases is treating the trail as the amenity.

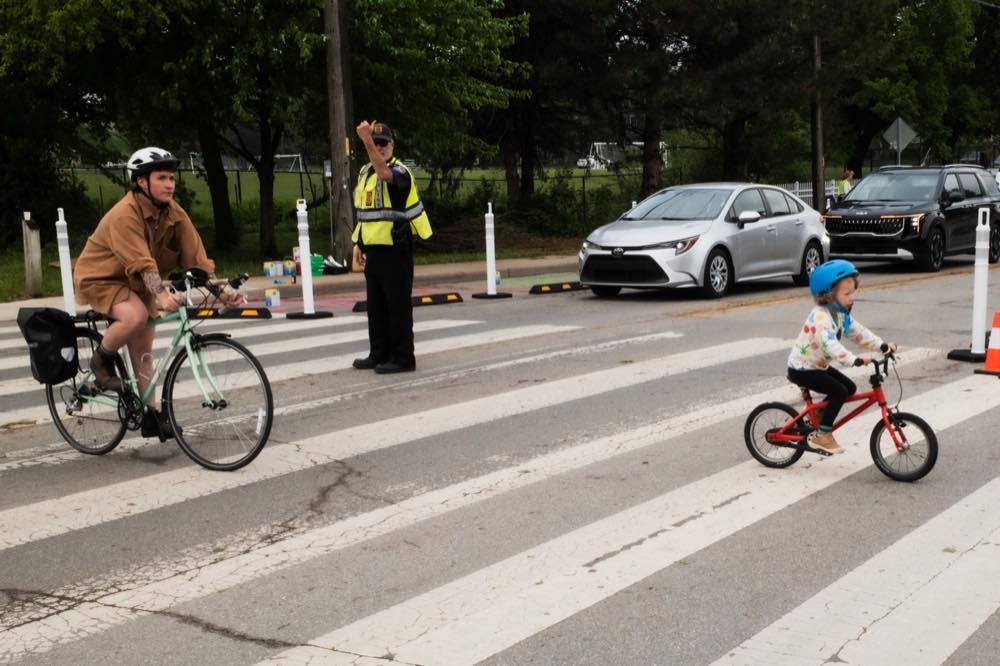

The crossing in use after the build.
Check our work
The underlying data is published in full
Responses were cleaned under a written decision log covering duplicate submissions, one repeat
submitter whose two responses contradicted each other (both excluded), and conditional questions
nulled where they did not apply. The dataset was frozen on July 15, 2026, and every number on this
page traces to that frozen file. Quotes in the community report are verbatim and anonymous. Of the
123 respondents, 90 signed the petition and 89 consented to have their signature shared with the
City; those names and addresses go to the City separately under that consent and appear in no
published document.
Everything below is the source material, released so that anyone can reproduce the findings above
or reach their own.
Download the survey data
We removed names, contact information, precise submission timing,
linked geography, and raw narrative responses to protect participants while preserving the
structured evidence behind our published findings.
CSV · Row-level data
De-identified survey responses
Privacy-reduced categorical responses for independent analysis, with rare values generalized
or excluded.
For a concise record of the cleanup, generalization, suppression, and
validation steps, read the survey-data
processing actions. The internal decision log is not included in the public release.
Download the speed-study data
Volunteer names and initials were replaced consistently with
Volunteer A through Volunteer P, while source paths and handwritten notes were removed. The
release preserves the structured PRE/POST measurements and analysis tables while reducing
the chance that individual data-collection volunteers can be identified.
ZIP · Complete release
Complete speed-study package
All four de-identified source tables, 11 analysis tables, and documentation in one download.
